Choosing paving tools
The list above is what exists. This is how to decide which of it you actually need, what separates a tool worth keeping from one that ends up at the back of a drawer.
The sub base carries the load
Paving does not carry weight, it spreads it onto a compacted sub base which does. That means excavating deeper than the slab thickness: typically 100mm of compacted MOT type 1 for a patio and 150mm or more for a driveway, plus the laying course and the slab.
Compacted is the operative word. Loose hardcore of the right depth settles unevenly under use, which is why a patio develops dips a year later. It goes in in layers of no more than 100mm and each layer is compacted before the next.
- The sub base carries it
- Not the slab. Excavate for sub base plus laying course plus slab thickness.
- 100mm patio, 150mm drive
- Compacted MOT type 1. More on soft ground or clay.
- Compact in layers
- No more than 100mm at a time. A thick loose layer never compacts through.
- Dig out soft spots
- A soft patch under a compacted base is where the paving will sink.
Falls, and where the water goes
Paving needs a deliberate fall of about 1 in 80 away from the building, so water runs off rather than pooling or running toward a wall. Flat paving holds water, which then freezes, and freeze thaw is what lifts and spalls a surface.
Two other rules matter near a house. Paving must not bridge the damp proof course, which means finishing at least 150mm below it, and water must not be directed toward an air brick or a doorway. Both are common and both cause damp inside.
- 1 in 80 away from the building
- About 12mm per metre. Flat paving holds water and freeze thaw lifts it.
- Below the damp proof course
- At least 150mm. Paving bridging the DPC puts damp into the wall.
- Not toward air bricks
- Or doorways. Check where the water actually ends up, not just that it moves.
- Permeable if it is a drive
- Front garden paving over 5 square metres needs permeable construction or drainage.
Full bed, not five dabs
Slabs go on a full mortar bed or a compacted sharp sand course, in full contact. The five spot method, with a dab at each corner and one in the middle, leaves the slab unsupported between and it cracks when something heavy lands on it.
Block paving is different: it goes on a screeded sand course, laid slightly high, then vibrated down with a plate compactor so the blocks lock together. The sand is not compacted before laying, because the blocks compact it.
- Full bed for slabs
- Continuous mortar or compacted sand. Five dabs leaves the slab unsupported and it cracks.
- Screeded sand for blocks
- Uncompacted, laid to a depth, then vibrated down with the blocks in place.
- Lay slightly high
- Block paving drops as it is compacted, typically about 10mm. Allow for it.

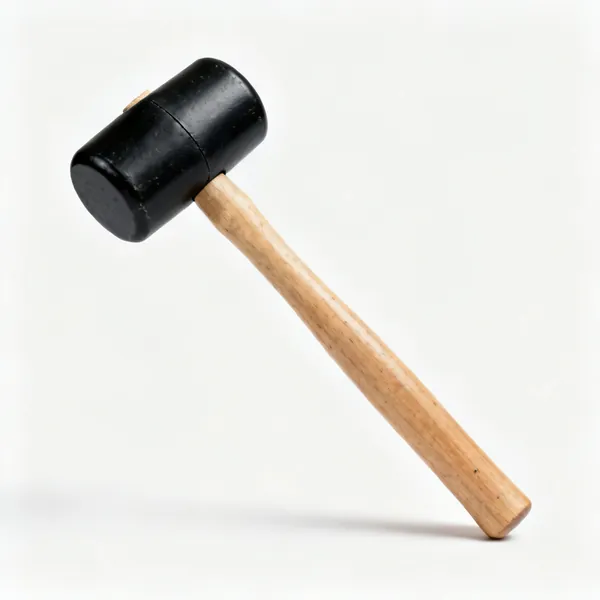

- Tap down, do not lever
- A rubber mallet and a level. Levering a slab breaks the bed under the next one.
Edge restraint holds it all together
Block paving works by interlock: each block is held by its neighbours. Without a restrained edge the outer blocks creep outward, the joints open, and the whole area gradually loosens from the outside in.
Restraint means a haunched kerb, an edging course bedded in concrete, or a proprietary edging system. It is not optional on block paving, and on slabs it is what stops the perimeter dropping and the jointing cracking out.
- Blocks need restraint
- The interlock only works if the edge is held. Otherwise it creeps outward.
- Haunched in concrete
- An edging bedded and haunched, not simply laid on sand at the perimeter.
- Do it before the field
- Edges set first give a reference to lay to and cannot be pushed out later.
- Slabs benefit too
- It stops the perimeter dropping, which is where jointing cracks out first.
Jointing and what grows in it
Kiln dried sand brushed into block paving joints and vibrated in is what completes the interlock, and it needs topping up after the first few weeks as it settles. Ordinary sand is too damp and will not flow into the joint.
For slabs, a brush in resin jointing compound resists weeds and does not wash out, unlike a dry sand and cement mix which stains the slab face and cracks. Whatever is used, it goes in when the paving is dry and the joints are clean.
- Kiln dried sand for blocks
- Dry so it flows in. Ordinary sand is too damp to reach the bottom of a joint.
- Top up after a few weeks
- Sand settles as the paving is used. The interlock depends on full joints.
- Resin jointing for slabs
- Resists weeds and does not wash out. Dry sand and cement stains the slab face.
- Joints must be dry and clean
- Any jointing compound applied over damp or dirty joints fails at the bond.
Frequently asked questions
- What tools do I need for paving?
- A spade and wheelbarrow, a plate compactor, a rake, screed rails and a screed bar, a rubber mallet, a spirit level, a string line, a block splitter or disc cutter, and a stiff brush for jointing. Plus knee pads, since most of it is done kneeling.
- How deep should a sub base be for a patio?
- About 100mm of compacted MOT type 1 for a patio and 150mm or more for a driveway, plus the laying course and the slab thickness on top. That is what you excavate to. On clay or soft ground it needs to be deeper.
- What fall should paving have?
- About 1 in 80, or roughly 12mm per metre, running away from the building. Flat paving holds water, which then freezes and lifts the surface. It must also finish at least 150mm below the damp proof course and not direct water at an air brick.
- Can you lay slabs on five dabs of mortar?
- It is common and it is why slabs crack. The slab is unsupported between the dabs, so a point load in the middle or a heavy planter breaks it. A full continuous mortar bed or a compacted sharp sand course supports the whole slab.
- Why does block paving need edge restraint?
- Because block paving works by interlock, with each block held by its neighbours. Without a restrained edge the outer blocks creep outward, joints open, and the area loosens from the outside in. A haunched kerb or edging course in concrete is not optional.
- What sand goes in block paving joints?
- Kiln dried sand, brushed in and vibrated so it reaches the bottom of the joint. Ordinary building sand is too damp to flow properly. Top it up after the first few weeks, since it settles with use and the interlock depends on full joints.
- Do I need planning permission to pave a front garden?
- For more than 5 square metres of a front garden, permitted development requires permeable construction or drainage to a soakaway rather than to the road. Traditional impermeable paving over that area needs an application.

- How do you cut paving slabs and blocks?
- A block splitter for blocks and thin slabs, which is quick, quiet and produces no dust. A disc cutter with a diamond blade for anything a splitter will not take, with water suppression and an FFP3 mask because the dust contains silica.
