Choosing excavation tools
The list above is what exists. This is how to decide which of it you actually need, what separates a tool worth keeping from one that ends up at the back of a drawer.
Find the services first
Buried electricity, gas, water and telecoms are rarely where the drawings say and rarely at the depth the regulations specify. Striking a live cable produces an arc flash that causes severe burns, and striking a gas main is worse.
The sequence is: get utility plans, sweep the line with a cable avoidance tool, mark what it finds, then dig trial holes by hand to confirm before any machine or breaker goes near. Plans alone are not a survey and a detector alone is not a confirmation.
- Plans, then detect, then hand dig
- All three. Each one catches what the previous one missed.
- Trial holes by hand
- Hand dig to expose a service before a machine or breaker gets near it.
- Arc flash burns
- Striking a cable does not trip a breaker and stop. It produces a flash and a blast.
- Assume nothing about depth
- Older services sit far shallower than the current rules require. Sweep the whole line.
Trench collapse, and why it surprises people
A cubic metre of soil weighs between 1.5 and 2 tonnes. A trench side that has stood all morning can fail without warning when the soil dries, when it rains, when a vehicle passes nearby, or when the spoil heap loads the edge.
Anything over about 1.2 metres deep needs support or battering back, and shallower trenches in poor ground do too. Being buried to the chest is enough to prevent breathing, so the depth people consider safe is above the depth that kills.
- Soil is heavy
- Well over a tonne per cubic metre. Waist deep burial prevents breathing.
- Support above 1.2 metres
- And in poor ground below it. Battering the sides back is the alternative.
- It fails without warning
- A side that stood all morning goes when the soil dries or a vehicle passes.
- Keep spoil back
- A heap at the edge loads the side it is standing on. A metre clear, minimum.
Getting in and out, and what falls in
A ladder in the trench, within a short distance of anyone working, secured at the top. Climbing out using the sides breaks them down and is also how people are trapped when a side goes while they are on it.
Then edge protection so nobody and nothing falls in. Barriers around the excavation, stop blocks where vehicles tip near it, and covers or fencing overnight. A person falling into a trench is a separate hazard from the trench collapsing.

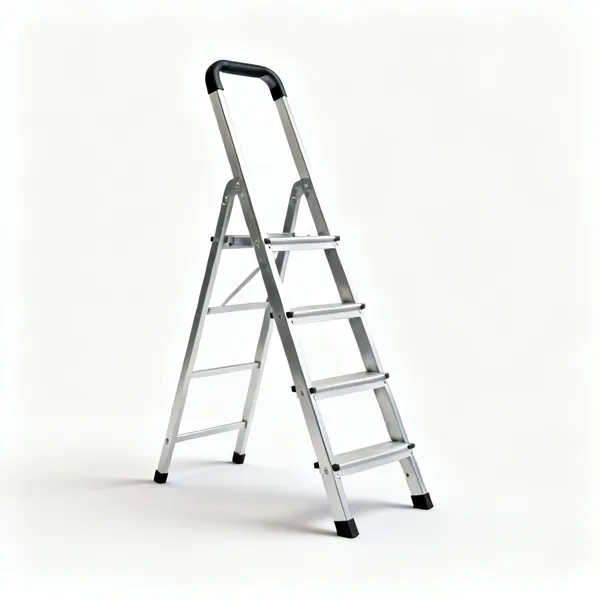

- Ladder, secured, close by
- Not climbing the sides, which breaks them down and traps people mid climb.

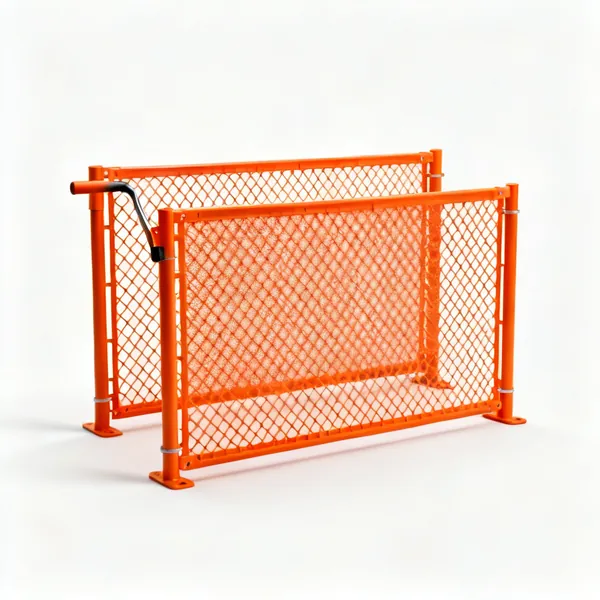

- Barriers all round
- Falling in is a separate risk from collapse. Both need addressing.
- Stop blocks for vehicles
- A reversing vehicle tipping near an edge loads it and can go in.

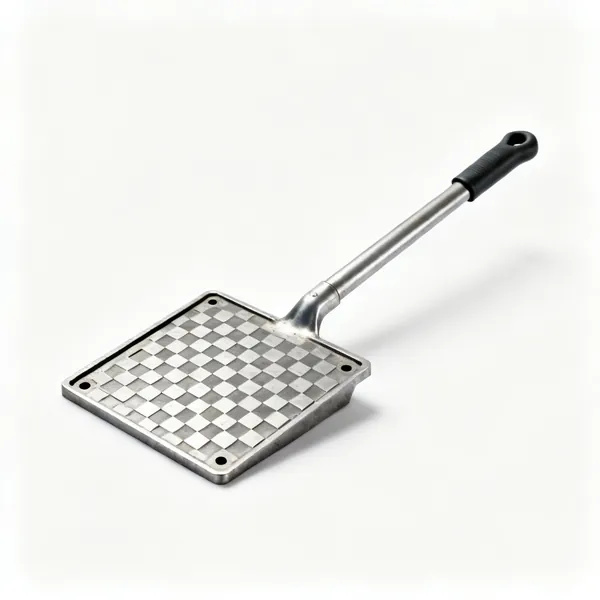

- Cover or fence overnight
- An open trench on an accessible site is a hazard to anyone, not just workers.
Water, and what it does to ground
Water changes everything about a trench. Saturated soil is heavier, loses cohesion and flows, so a trench that was stable in dry ground becomes unstable within hours of rain. A trench that fills also drowns people who cannot climb out.
Pump it out, and be prepared for the sides to have changed while it was full. Where groundwater is present continuously, the excavation needs a designed approach rather than a bigger pump.
- Wet ground loses cohesion
- A stable dry trench can become unstable within hours of rain.
- Pump, then reassess
- The sides changed while it was full. Do not just get back in.
- Drowning is a real risk
- A filling trench with no easy exit. This has killed people in shallow trenches.
- Continuous groundwater needs design
- Not a bigger pump. That is a job for an engineered solution.
Backfilling and compacting properly
Backfill in layers, compacting each one, rather than filling and hoping. Uncompacted backfill settles for years, which shows up as a dip in a drive, a cracked slab, or a pipe that has been left unsupported and then fails.
Bedding matters equally. A pipe or cable laid on a stone gets a point load and eventually breaks there, so it goes on sand or pea gravel and gets surrounded before anything coarse goes back in. Marker tape above services is a five minute job that saves the next person's life.
- Layers, compacted
- 150 to 300mm at a time. Fill and hope settles for years afterwards.

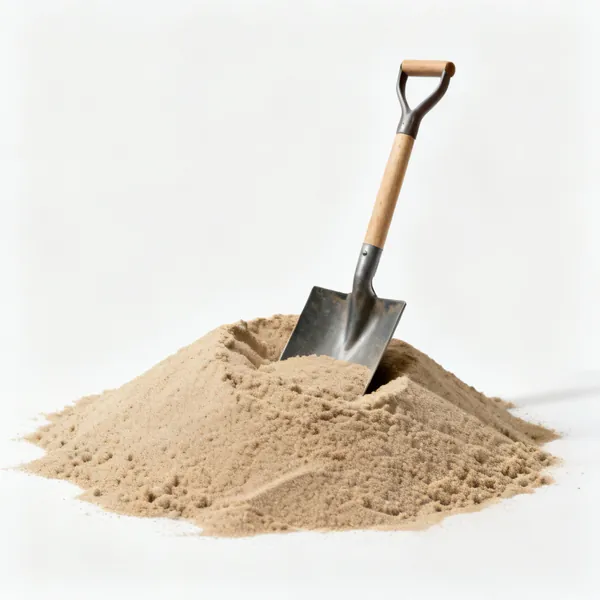

- Bed on sand
- A pipe on a stone gets a point load and fails there. Surround before backfilling.
- Marker tape above
- Coloured tape over a service so the next person digging finds it before hitting it.
- Record what you buried
- A photograph with a measurement. The next person will not have the plans either.
Frequently asked questions
- What tools do I need for excavation?
- A cable avoidance tool, a spade and a shovel, a fork, a pick and a breaker for hard ground, a laser or level for depth, and trench support or a way to batter the sides back. A mini digger for anything more than a short run.
- How do I find buried services before digging?
- Get utility plans, sweep the line with a cable avoidance tool and a signal generator, mark everything it finds, then hand dig trial holes to confirm before any machine or breaker gets near. All three steps, since each catches what the others miss.
- How deep can you dig a trench without support?
- Above about 1.2 metres it needs support or the sides battered back, and in poor or wet ground shallower trenches do too. A cubic metre of soil weighs well over a tonne, and being buried to the chest is enough to prevent breathing.
- Why do trenches collapse without warning?
- Because the failure conditions change while the trench looks the same. Soil drying out, rain saturating it, vibration from a nearby vehicle, or a spoil heap loading the edge can all trigger a side that stood perfectly well all morning.

- What is a trench box?
- Two steel panels held apart by adjustable struts, lowered into a trench to support both sides at once. Faster than timber shoring and it works in a trench that is already open, which is why it is the standard solution for service work.
- How far should spoil be kept from a trench edge?
- At least a metre, and further in poor ground. A spoil heap at the edge is a surcharge load on the very soil holding the side up, which makes a collapse considerably more likely rather than just getting in the way.
- How should you backfill a trench?
- In layers of 150 to 300mm, compacting each one before the next. Uncompacted backfill settles for years, producing dips, cracked slabs and unsupported pipes. Bed pipes and cables on sand rather than directly on stone, and lay marker tape above them.
- Do I need a permit to dig?
- For work in a public highway or footpath, yes, and utility companies have their own permit requirements near their apparatus. On private land it depends on depth, proximity to boundaries and whether the work affects a structure or a protected tree.
